How Long Does It Take to Build a Pool in Southern California?

pool dig, how long it takes to build a pool in SoCal

Planning a Pool? Here’s What to Expect for Your Timeline

If you’re thinking about adding a swimming pool to your Southern California home, one of the first questions that likely comes to mind is: How long is the pool construction process going to take?

It’s an important question—especially if you’re hoping to be swimming by summer or planning ahead for a special event. While every project is unique, there is a general timeline most homeowners can expect when working with Majestic Pool Construction. Knowing what happens at each stage will help you plan with confidence and avoid common delays.

Below is a realistic, step-by-step breakdown of the typical pool construction timeline in Southern California.

The Average Timeline: 8–14 Weeks from Start to Finish

On average, building a custom inground pool in Southern California takes 8 to 14 weeks, depending on design complexity, city permit timing, weather, and additional features such as spas, baja shelves, fire elements, or custom hardscaping.

The timeline includes the following phases:


Phase 1: Design & Engineering (2–4 Weeks)

Before construction begins, the project starts with design and planning. This stage is focused on turning your ideas into a practical, buildable plan.

This step includes:

  • Initial consultation and design concepts
  • Finalizing the pool layout, depth, features, and materials
  • Engineering to ensure structural integrity for SoCal soil and seismic conditions

This stage is also when most homeowners decide on optional features like waterfalls, sun shelves, lighting, and equipment upgrades. The more prepared you are with your vision, the faster this phase moves.


Phase 2: Permits & Approvals (2–6+ Weeks)

Southern California cities require permits for pool construction, and the processing time varies significantly by municipality and season. Some cities move quickly, while others take longer—especially during spring and early summer when applications spike.

Permit requirements often include:

  • Structural and building permits
  • Plumbing and electrical permits
  • Safety barrier compliance approvals
  • Property line setback review

Starting early is key. This is the #1 step that can affect your overall timeline. While Majestic Pool Construction handles the permitting process for you, it’s important for homeowners to understand that approval timelines are affected by the city, not the builder.

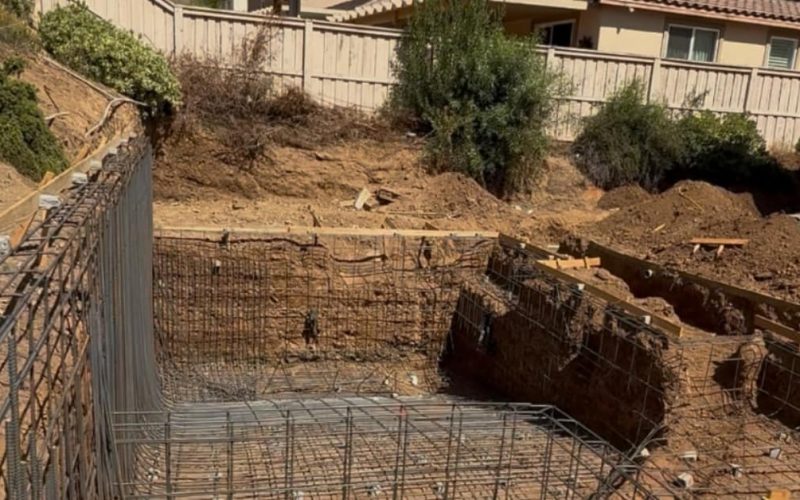

Phase 3: Excavation (3–7 Days)

Once permits are cleared, excavation begins. This is when the pool area is dug according to the approved design and engineering plans.

Most excavations take 3 to 7 days, depending on soil conditions, access to the yard, and whether rock or hard soil is encountered. Southern California has a mix of sandy, clay, and rocky soil depending on the region, so each dig can vary.


Phase 4: Steel, Plumbing & Electrical (2–3 Weeks)

After the dig, the pool begins taking shape:

  • Steel rebar is installed to reinforce the pool’s structure
  • Plumbing lines, drains, and return lines are placed
  • Electrical conduits and bonding are installed for safety and equipment power

This stage also includes inspections to ensure everything meets local building codes.


Phase 5: Shotcrete or Gunite Application (1–2 Weeks)

With the structural layout in place, the shotcrete or gunite shell is applied. This forms the solid, long-lasting foundation of your pool. After installation, the material must cure before the next steps proceed.

In most cases, the curing period is 7–10 days. Homeowners may be asked to lightly water the shell during this time to prevent premature drying or cracking.


Phase 6: Tile, Coping & Decking (2–4 Weeks)

Once the shell is cured, the pool begins to take on its visual character:

  • Waterline tile is installed
  • Coping is placed around the pool edge
  • Decking is built, which may include concrete, pavers, stone, or custom hardscaping

The duration of this stage varies based on material selection and the complexity of your outdoor living design. If you’re building a full backyard experience—such as a fire pit, outdoor kitchen, pergola, or landscaping—this stage may extend slightly.


Phase 7: Interior Finish & Startup (3–7 Days)

The final interior finish (such as plaster or pebble) is applied, followed by filling the pool with water. Once filled, Majestic performs a startup process to balance water chemistry and ensure equipment is operating properly.

After startup, the pool is ready to enjoy.


What Can Speed Up or Delay the Process?

Every build is different, but here are the most common timeline factors:

Speed Boosters:

  • Making material selections early
  • Starting design and permits before peak season
  • Quick communication and approvals from the homeowner

Potential Delays:

  • City permit bottlenecks
  • Last-minute design changes
  • Limited yard access requiring additional prep
  • Weather delays (mainly rare rainstorms)

When Should You Start if You Want to Swim by Summer?

If your goal is to have the pool ready by June, you should begin the process between January and March. This allows time for design, permitting, and construction without rushing.

Starting in the fall is ideal for those who want zero timeline pressure and prefer to enjoy their new pool as soon as warm weather arrives.

Why Southern California Timelines Are Unique

Unlike many other states, Southern California benefits from a climate that allows for pool construction year-round. This means you don’t need to wait for spring to begin—the best builders are actually busiest then.

This makes late fall, winter, and early spring the most strategic seasons to start, ensuring you avoid waitlists and permit backlogs.

Build With Majestic Pool Construction

Creating a custom pool is a major investment, and choosing a builder who communicates clearly and manages the timeline efficiently will make the experience smooth and enjoyable.

At Majestic Pool Construction, we guide you through each step, provide realistic expectations, and keep the process moving from planning to first swim. Contact us.
